ERCOT has proposed a power variation limit for large computational loads. The peak-to-peak change in a site’s active power, filtered to keep everything from 0.1 Hz to 55 Hz, may not exceed 10 MW in any rolling 5-second window. ERCOT presented the proposal to its Large Load Working Group in February, April and June 2026 and said it would file the revision request in the second quarter of 2026. As of October 5, 2026 no revision request carrying the limit appears in ERCOT’s list of pending requests, so the limit is a proposal and its final wording can still change.

The number is small on purpose. A large AI campus running one training job can swing by hundreds of megawatts, so ten megawatts is a small fraction of it. The study ERCOT commissioned names energy storage, hardware and software as the ways to get there, and a battery between the load and the grid is the one that does not change how the computers run.

AI training moves power in square pulses

A training job runs the same cycle again and again: every GPU computes, then they all wait to exchange results, then they compute again. Power follows the cycle. It rises to the cluster’s peak during compute and drops during the exchange, in steps measured in milliseconds, every 20 seconds or so, thousands of times a day. When one job spans a campus, the whole campus moves together.

Why ERCOT cares: generator shafts are springs

ERCOT’s concern is the large spinning generators near these loads. A turbine-generator shaft is a row of heavy masses (the turbine stages and the generator) joined by long steel shafts that twist like springs. Each shaft has natural torsional frequencies. In ERCOT’s example the five modes run from 14 Hz to 54.3 Hz. When the electrical load on the generator varies at or near one of those frequencies, the twisting builds up. That is called sub-synchronous oscillation. Cyclic twisting fatigues the shaft over months and years, and a strong resonance can break it.

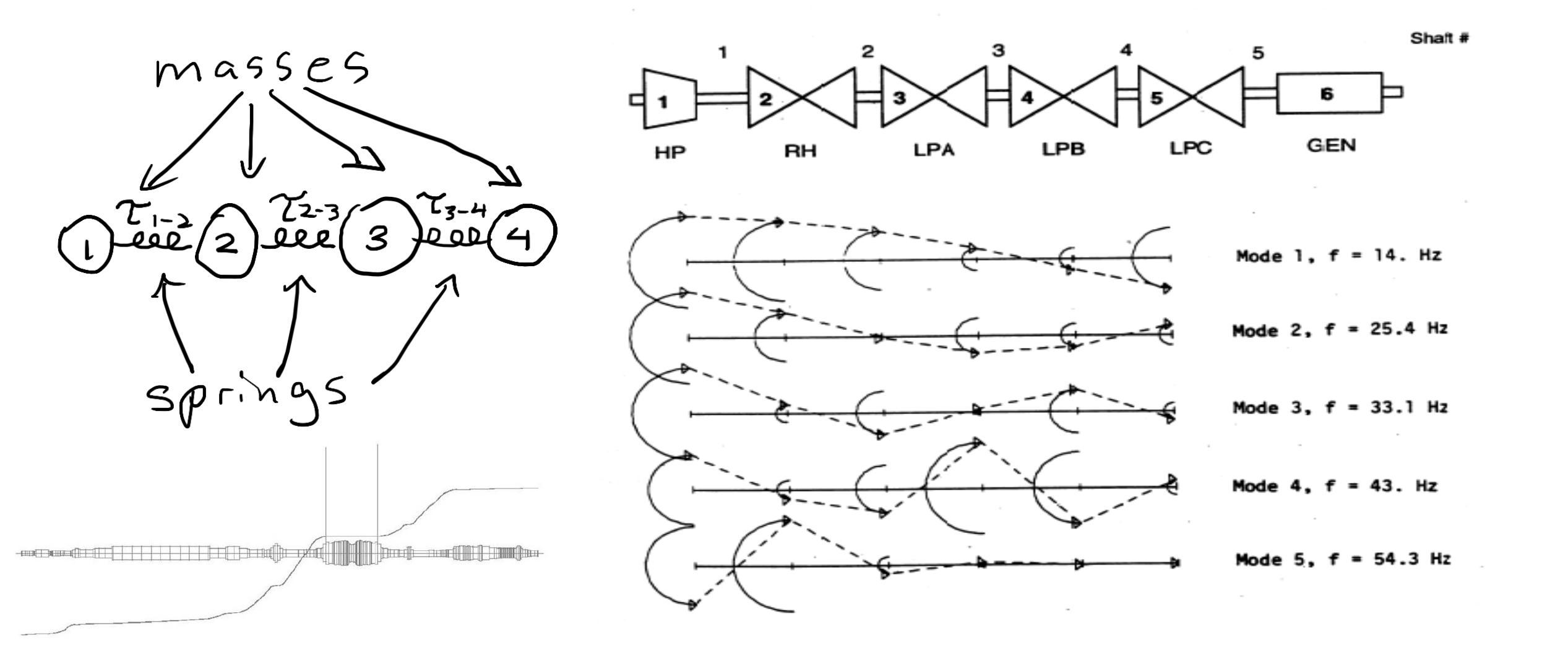

A turbine-generator shaft modeled as masses joined by springs, with its five torsional modes between 14 Hz and 54.3 Hz. This is the mechanism by which a fluctuating load becomes cyclic stress in a generator shaft.
SOURCE: ELECTRANIX FOR ERCOT, LLWG, OCTOBER 24, 2025, SLIDE 6A turbine-generator shaft modeled as masses joined by springs, with its five torsional modes between 14 Hz and 54.3 Hz. This is the mechanism by which a fluctuating load becomes cyclic stress in a generator shaft.

ERCOT hired Electranix, a power system studies firm, to measure the effect. In its October 2025 study a 100 MW generator with a 12 Hz torsional mode sat electrically close to a large load. A load following a measured AI training profile produced about 4 percent alternating torque on the shaft. The same profile with a 12 Hz component in it produced alternating torque of about 1 per unit, roughly the generator’s full rated torque, swinging back and forth. A square wave between 25 and 100 MW at 12 Hz produced more than 5 per unit. Electranix concluded that the risk depends first on the load’s cycling and ramping, and second on how electrically close the load is to the generator.

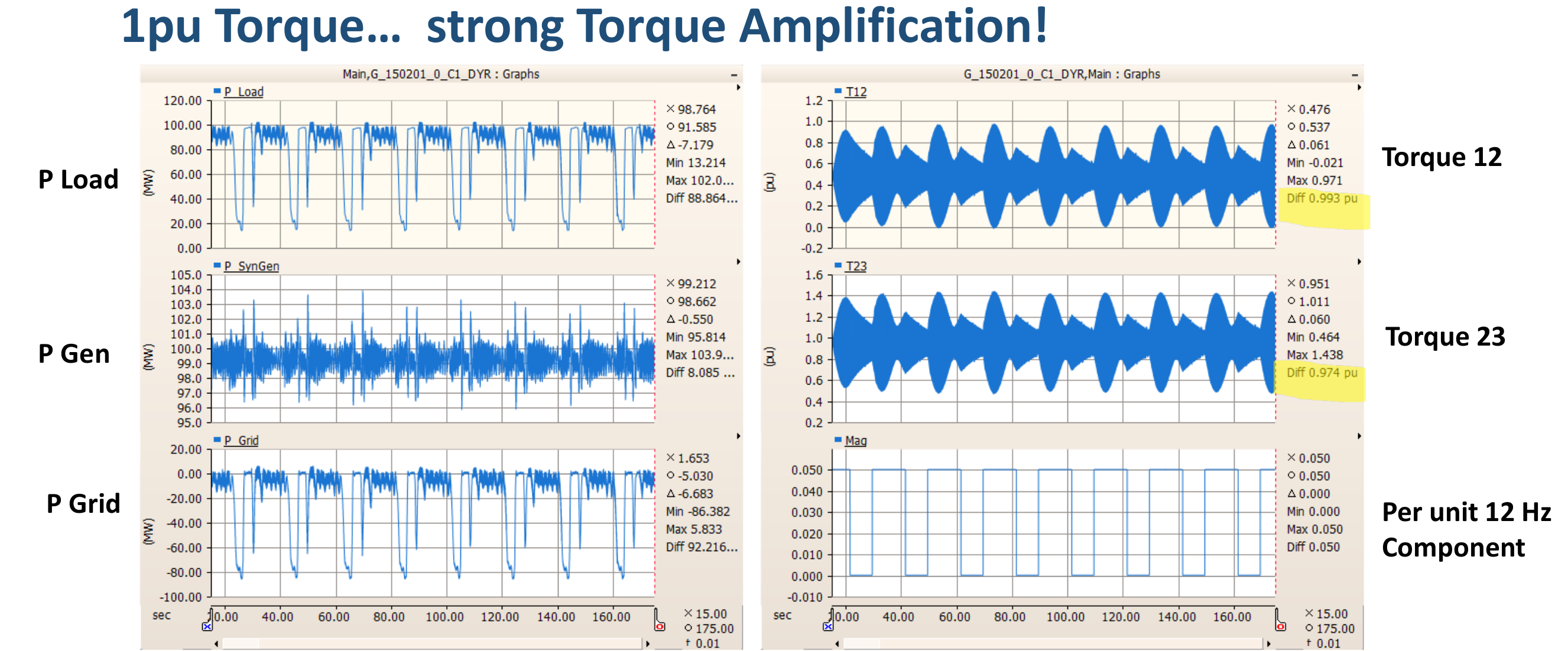

Electranix simulation for ERCOT: a load following an AI training profile with a 12 Hz component (top left) drives alternating shaft torque of about 1 per unit between the generator’s shaft sections (right).
SOURCE: ELECTRANIX FOR ERCOT, LLWG, OCTOBER 24, 2025, SLIDE 11Electranix simulation for ERCOT: a load following an AI training profile with a 12 Hz component (top left) drives alternating shaft torque of about 1 per unit between the generator’s shaft sections (right).

This is not only a simulation. ERCOT lists field events: a 23 Hz oscillation in ERCOT from July to October 2024 and, outside Texas, a 14.7 Hz oscillation traced to a data center, among others. The study’s own recommendation is direct: “Measures should be taken to mitigate software cycling via energy storage or hardware/software solutions. While perfect flatness is not required, active power must be sufficiently stable by the time it is introduced to the grid.”

Why the limit is 10 MW

ERCOT injected power variation at every bus of 100 kV or more on its system and counted the generator stations pushed past an assumed limit of 1 percent of their rating, leaving out units under 20 MVA. At 5 MW no station was affected. At 10 MW, 7 were. At 15 MW, 20 were, and at 25 MW, 50 were. ERCOT’s reading is that raising the limit, even modestly, sharply increases how far one load’s swing reaches into the system.

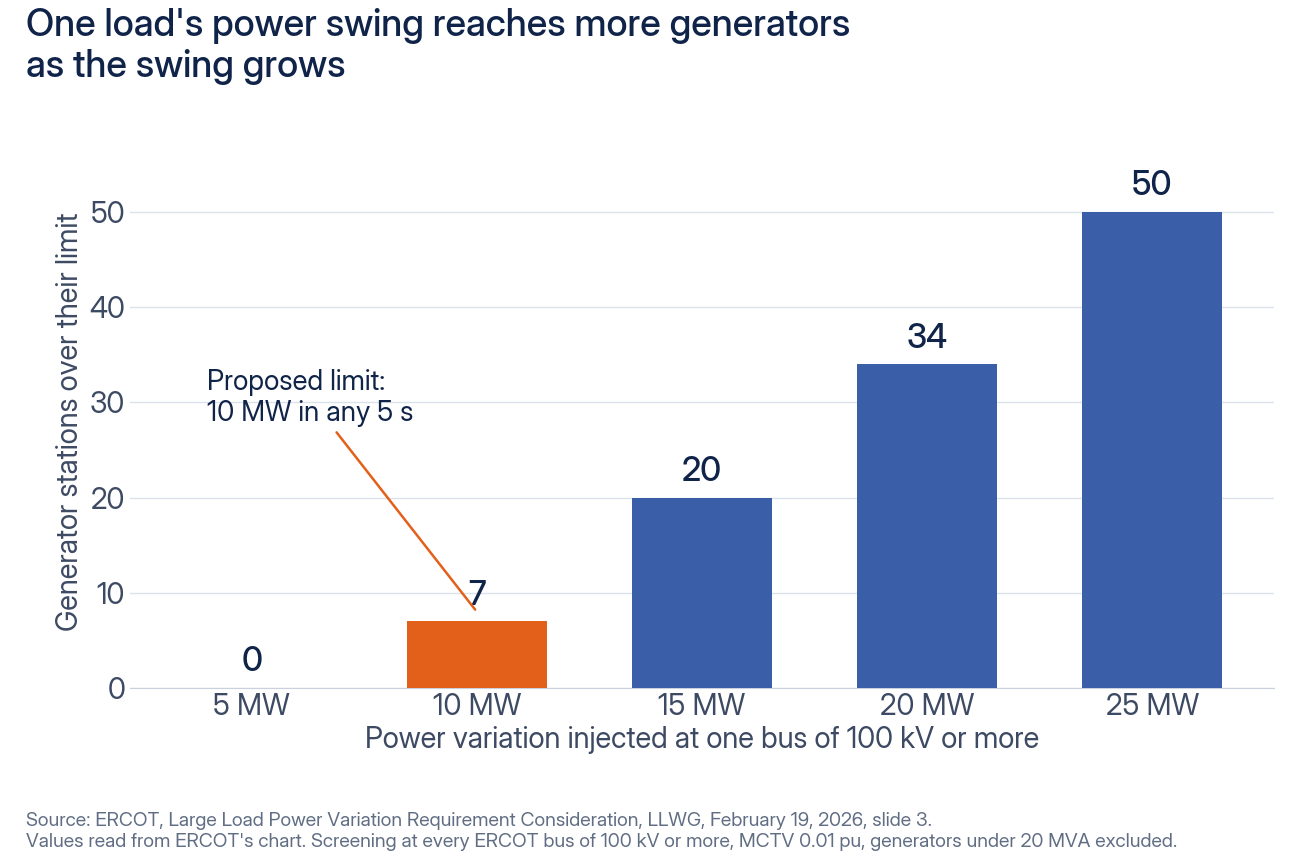

ERCOT’s screening of every bus of 100 kV or more: the number of generator stations over their limit rises from 0 at 5 MW of injected variation to 50 at 25 MW.
BATTALION ENERGY / FROM ERCOT LLWG DATA, FEBRUARY 19, 2026ERCOT’s screening of every bus of 100 kV or more: the number of generator stations over their limit rises from 0 at 5 MW of injected variation to 50 at 25 MW.

ERCOT also chose a single number so that loads can connect without a site-specific study. A study of how one load interacts with nearby generator shafts needs detailed generator data that is often hard to obtain, and the studies grow quickly as the allowed variation grows. ERCOT weighed project-specific limits, a tiered approach and a uniform limit, and proposed the uniform 10 MW.

How compliance would be measured

The June 2026 proposed language reads: “The peak-to-peak value of active power variation, calculated using instantaneous voltages and currents and filtered to preserve frequency components from 0.1 Hz to 55.0 Hz, shall not exceed 10 MW over any rolling 5-second interval.”

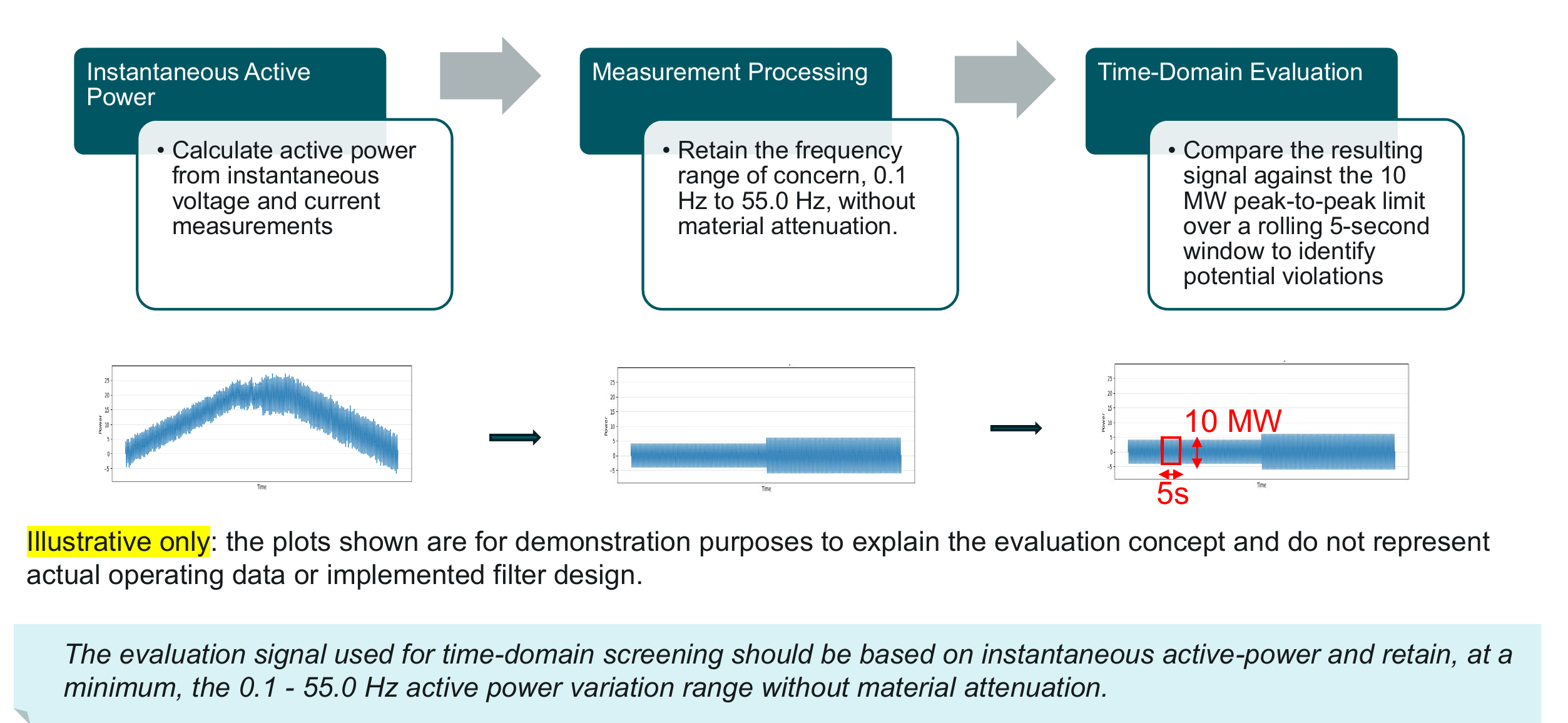

ERCOT’s proposed evaluation: compute active power from instantaneous voltage and current, keep the 0.1 to 55 Hz content without material attenuation, and compare the result to 10 MW peak to peak over a rolling 5-second window. ERCOT marks the plots as illustrative.
SOURCE: ERCOT LLWG, JUNE 19, 2026, SLIDE 3ERCOT’s proposed evaluation: compute active power from instantaneous voltage and current, keep the 0.1 to 55 Hz content without material attenuation, and compare the result to 10 MW peak to peak over a rolling 5-second window. ERCOT marks the plots as illustrative.

Three points follow from ERCOT’s slides. The band from 0.1 to 55 Hz covers both slow inter-area swings and the torsional frequencies of generator shafts. ERCOT said in February that its focus is repetitive cycling above 10 MW, and that an infrequent step above 10 MW would not violate the criterion. Measuring it needs fast recording. ERCOT said in April that phasor measurement units may need more than 30 samples per second, that fault recorders may need new triggers, and that it is working with transmission owners on that monitoring.

How a battery meets the limit

A battery under the control of an energy management system (EMS) absorbs the training pulses so the grid sees a steady draw. It discharges when the load rises and charges when it falls, so the sum of load and battery stays within the limit. The Battalion EMS and controllers do this with battery and UPS equipment from leading vendors, and Energence simulates a site against the proposed limit before it’s built.

The same controls also cover ride-through. ERCOT’s NOGRR 282 requires large computational loads to stay connected through grid faults, and the ride-through post explains why. More is on the data center power smoothing page. Send your load profile with its time resolution and the interconnection agreement, and request information to see your site simulated against the limit.
